top of page

Premier Modular v Maidstone: the NEC Accepted Programme lesson behind a £1.65m ruling

Jun 20
7 min read

Updated: Oct 30

By Roman Bazelchuk | NEC Accredited Project Manager | APMG Project Planning and Control

Founder, NEC Planning Solutions Ltd

A June 2026 High Court ruling refused to enforce a £1.65m NEC adjudication award because the adjudicator decided the case on a programme that neither side said was the Accepted Programme. The legal headline is natural justice. The lesson for contractors is older and plainer. A compensation event is only as good as the NEC Accepted Programme it stands on.

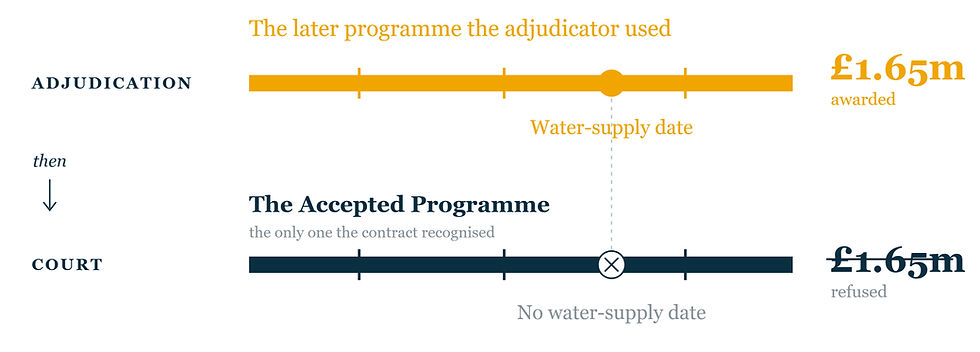

Illustrative annotated extract of two programmes for Premier Modular v Maidstone, decided in the Technology and Construction Court on 10 June 2026. Top: the Accepted Programme, the original at contract, with modules, M&E installation, testing and commissioning, and Completion, and a red dashed box where no date for the permanent water supply appears. Bottom: a later revision issued by the contractor and never accepted, which adds a Client milestone for the permanent water supply, marked in red and linked into testing and commissioning. The award relied on that date; under clause 60.1(3) the date that counts is the one on the Accepted Programme.
Figure 1: the two programmes behind Premier Modular, illustrated: the Accepted Programme set no date for the permanent water supply, and the later revision that did was never accepted.


On 10 June 2026 the Technology and Construction Court refused to enforce an adjudicator's award of £1,655,385.49 in Premier Modular Ltd v Maidstone and Tunbridge Wells NHS Trust. The contract, based on NEC4 Option A, was for a new modular theatre block at Maidstone Hospital, tendered at close to £19.8m. The contractor said the Trust's late provision of a permanent mains water supply, needed for testing and commissioning, was a compensation event. An adjudicator agreed and put it at £1.65m. The court would not enforce that decision.


Most of the commentary will sit on natural justice, and fairly so. The judge found the adjudicator had gone off on a "frolic of his own", deciding the dispute on a basis neither party had argued and that the Trust had no real chance to meet. The law firms will cover that ground well. What follows is the other reading, the one a planner sees first. The £1.65m did not fall apart in court. It fell apart on the project, in how the programme was accepted and in what the accepted baseline did and did not contain.



What the case actually turned on


The parties agreed on one point, and it proved decisive. The only Accepted Programme under the contract was the original, the one attached to it at the outset, and that programme set no date by which the permanent water supply had to be provided. No later programme had ever been accepted by the project manager. So at the moment the contractor needed to show the Trust had missed a required date, the accepted baseline held no such date to miss.


The adjudicator closed that gap himself. He found that a later, contractor-issued programme had effectively become the Accepted Programme, then used it to conclude that the Trust had been late with the water, which is where the compensation event and the money came from. The trouble was that no one had run that argument. Both sides had agreed the Accepted Programme was the original. Deciding the case on a different one, without ever putting it to them, was the unfairness that cost the award its enforceability.


A point of fairness cuts the other way too. The court did not find that the contractor was wrong about the delay, or that nothing was due. It found that the path to the answer was unfair. The underlying claim is still open and can be brought again, properly. The contractor may well have been delayed, and may well be owed. What it did not have was the one document that could have proved it.



Why the NEC Accepted Programme was central to the case


Take the natural justice point away and a project controls failure is left standing in the open. A compensation event under Clause 60.1(3) is, at bottom, a claim that the client missed a date the contractor was entitled to rely on, and that date is the one shown on the Accepted Programme. If the dependency, here a water supply the client had to provide, never appears in an accepted programme, there is no accepted date for the client to have missed, and that route has nothing underneath it.


This is the same trap worth seeing in full, what happens to a compensation event when there is no accepted programme. The case is only the most expensive recent version of it. By the time of the dispute the water supply was the entire argument, and it sat nowhere in the one programme the contract recognised.



Acceptance is a status you earn, not one you assume


Under NEC4 ECC a programme does not become the Accepted Programme by being issued, by being the newest version, or by being the one the site is actually working to. It becomes the Accepted Programme when the project manager accepts it, or when acceptance follows because the project manager let the two weeks allowed by Clause 31.3 pass, the contractor notified that failure and a further week passed without a reply. Clause 31 governs the first programme and its acceptance, Clause 32 the revisions. Getting a programme built and accepted under those clauses is a discipline of its own, and it is precisely the discipline that was missing here.


Let later programmes pile up without ever taking them through acceptance, and the baseline the contract recognises stays frozen at the original, however stale it has become. Every entitlement resting on a date added since then, a moved access date, a fresh client dependency, a resequenced milestone, becomes unprovable, because the accepted baseline does not carry it. The water supply shows the point exactly. It was the heart of the dispute and absent from the only programme that counted.



The notice point in the background


There was a second defence worth flagging. The Trust argued that even if a compensation event existed under the grounds relied on, the contractor had not notified it inside the time the contract demands, the time bar at Clause 61.3. The court did not have to resolve it, but it is a useful reminder that NEC entitlement runs on two disciplines at once. The programme has to carry the cause and effect. The notice has to land in time. A contractor strong on one and loose on the other is exposed, and a great deal of real entitlement is lost every year on the notification clock alone.



What this means for contractors


None of the lessons here are legal. Take every programme through acceptance, or force the point by notifying the project manager's failure to respond, so the baseline you lean on is one the contract recognises. Get the dates and dependencies owed by the client and others, the very things most likely to trigger a compensation event, into that accepted baseline rather than into a working file on someone's laptop. Notify compensation events inside the window. And do not walk into an adjudication leaning on a programme that was never accepted. The moment your entitlement depends on a baseline the other side never agreed and the contract never recognised, you are asking the tribunal to make your case for you. As this ruling shows, a tribunal that does so can hand you a number that will not survive enforcement.



And for project managers and clients


The discipline runs both ways, which is why it should hold the client's attention as much as the contractor's. A project manager who lets acceptance drift, who neither accepts a revised programme nor gives reasons within the two weeks Clause 31.3 allows, manufactures the exact ambiguity this case turned on. Accepting on time, or refusing on time and saying why, protects the client every bit as much as the contractor, because it keeps the baseline definite and keeps any later fight anchored to something both sides once signed. A current Accepted Programme is risk management for whoever is paying. It is not a favour to the other side.



How NEC Planning Solutions helps


NEC Planning Solutions Ltd is a UK-registered project controls consultancy, director-led, with senior NEC-accredited review on every output. The firm keeps the Accepted Programme where it belongs, current and recognised: Clause 31 and 32 submission and acceptance, compensation event assessment and quotation, forensic delay analysis, and independent programme assurance for contractors and project managers alike. It is the same work that, done in time, keeps a £1.65m entitlement on its feet instead of leaving it for an adjudicator to rescue.


Download the NEC4 Programme Acceptance Checklist

The pre-submission gate that keeps a programme acceptable under Clause 31 and 32, so the baseline your compensation events rely on is one the contract recognises. Direct download, no sign-up.






Need a programme the Project Manager can accept first time?


If submissions are coming back with reasons attached, or the accepted programme has fallen behind the job, NEC Planning Solutions puts the clause 31.2 content in place and keeps the revision cycle running to the contract.




FAQ


What did the court decide in Premier Modular v Maidstone?

On 10 June 2026 the Technology and Construction Court refused to enforce an adjudicator's award of about £1.65m under a contract based on NEC4 Option A. The adjudicator had decided the case on a later contractor-issued programme, although both parties agreed the only Accepted Programme was the original. Deciding on a basis neither side argued was a breach of natural justice.

Under clause 60.1(3), a failure by the client to provide something is measured against the date shown on the Accepted Programme. The only Accepted Programme was the original, and it set no date for the permanent water supply, so there was no accepted date for the Trust to have missed. The adjudicator filled that gap by treating a later programme as accepted, a point neither side had argued, and that is why the award was not enforced.

Only through acceptance. A programme does not become the Accepted Programme by being issued, by being the latest version or by being the one site works to. Under clause 31.3 it becomes accepted when the Project Manager accepts it, or is treated as accepted if the Project Manager does not reply within two weeks, the contractor notifies that failure and a further week passes.

No. The court did not find that the contractor was wrong about the delay or that nothing was due. It found that the route to the award was unfair, so the decision could not be enforced. The underlying claim remains open and can be brought again properly, but it will still have to be proved against a programme the contract recognises.

Take every revised programme through acceptance, or force the point by notifying the Project Manager's failure to reply, so the baseline you rely on is one the contract recognises. Put client dependencies and access dates into that accepted baseline, not a working file. Notify compensation events within the eight weeks in clause 61.3, and never go to adjudication on a programme that was never accepted.



About the author


Roman Bazelchuk is the Founder of NEC Planning Solutions Ltd, a UK project planning and controls consultancy supporting contractors with NEC programme compliance, compensation event assessments and live project controls. He is an NEC Accredited Project Manager and holds the APMG Project Planning and Control qualification, with a BEng in Mechanical Engineering and postgraduate training in Planning and Control.


NEC Planning Solutions provides contract-aware planning support through a QA-governed delivery model, helping project teams keep programmes accepted, current and commercially useful from tender through to live delivery.
